Interactive Project Study Area Map

Project Overview

The proposed EWN Runway 4-22 Improvement Program includes a 173-foot runway extension and extending the northern Runway Safety Area (RSA) from 600 feet to 1,000 feet in length. These improvements would also result in relocation of Williams Road (S.R. 1167), relocation of navigational aids, the airport perimeter road, and airport fencing, and acquisition of minimal amounts of right-of-way and an easement from NC/NS Railroad.

The Coastal Carolina Regional Airport Authority is required under the provisions of the National Environmental Policy Act (NEPA), and Federal Aviation Administration (FAA) and North Carolina Department of Transportation (NCDOT) to prepare an Environmental Assessment (EA) describing the anticipated environmental impacts of the proposed Runway 4-22 Improvement Program. Based on the evaluation, no resources would be significantly impacted by the No-action Alternative or the Proposed Action. The Proposed Action is not anticipated to result in an increase in the number of annual aircraft operations at EWN in comparison to the No-action Alternative.

The project includes relocating Williams Road (S.R. 1167) farther north, beyond the extended runway and RSA. This two-lane roadway provides a direct connection to U.S. 70. Scott Street (S.R. 1995) intersects Williams Road within the study area.

Project Highlights

  • Coastal Carolina Regional Airport proposes to construct a standard 1,000 foot-long RSA and maximize the length of Runway 4-22 with a 173-foot extension.
  • The RSA provides an unobstructed, graded and grassed surface to reduce the risk of injury to passengers, minimize damages to aircraft, and provide greater access to emergency responders if an aircraft overruns, undershoots, or veers off the side of the runway; RSA dimensions are based on FAA design standards and at EWN, the standard RSA is 500 feet wide and extends 1,000 feet beyond the runway end.

  • Relocated Williams Road, which would connect to Airline Drive includes:

    • a roundabout

    • two 12-foot travel lanes

    • 5-foot bike lanes

    • 3-foot paved shoulders, and open drainage

Project History

The NCDOT Division of Aviation’s Airport System Plan Update establishes a runway length of 6,500 feet for the 10 commercial service airports in NC and identifies EWN as not meeting this objective.   EWN is a critical component of the regional economy and provider of valuable airline service, despite having the shortest runway of any commercial airport in N.C.  The goal of the proposed project is to improve airfield safety and maximize the usable runway available to existing aircraft operators at EWN.

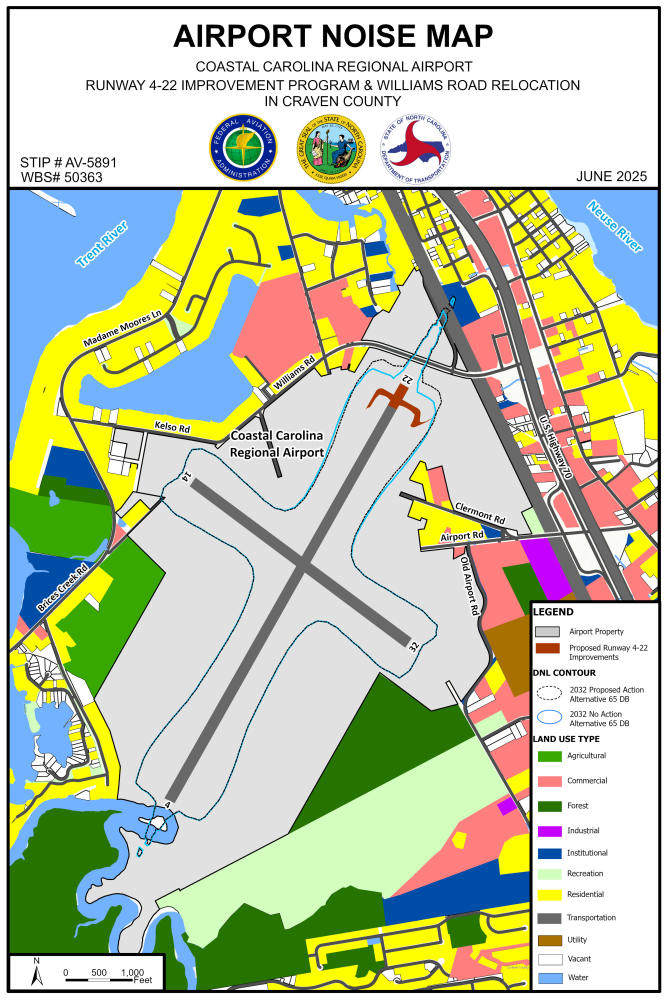

Project Map

Click on the link or the thumbnail below to view or download the map

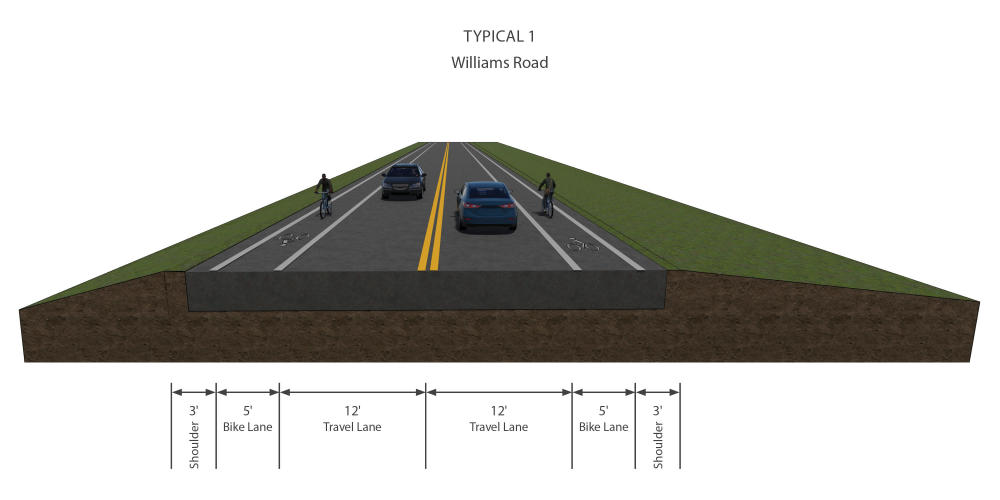

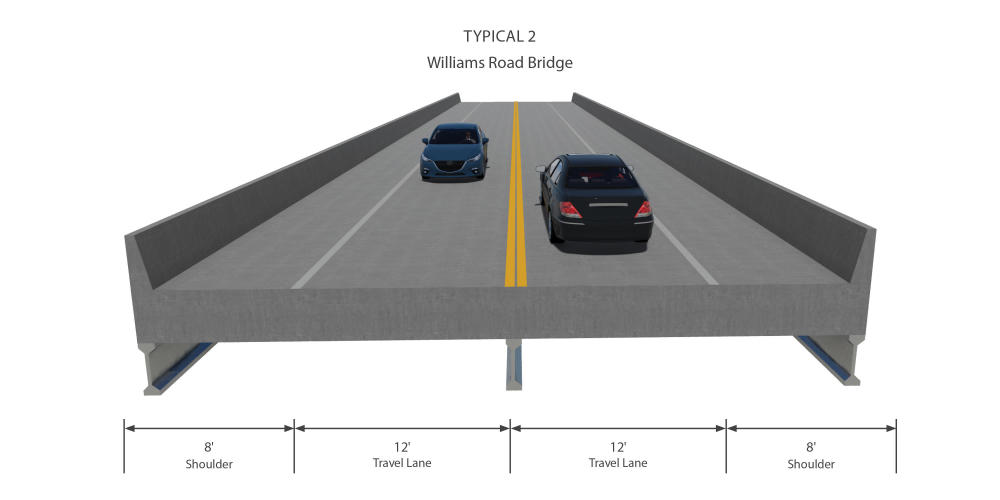

Typical Sections

Project Funding:

 Activity

 Costs*

Construction - Williams Road Relocation

$  6.00 Million

Construction - Airport Improvements

$ 6.72  Million

Total Cost

$ 12.72 Million

*Costs shown are estimates and are subject to change.

Project Timeline:

 Activity - Williams Road

Date*

Utilities

Fall 2026

Right of Way Acquisition

Spring 2026

Construction Begins

    Winter 2027

Activity - Airport

Date*

Finalized Airport Design

Summer 2026

Permitting

Fall 2026

Construction Begins

Winter 2027

*Future dates subject to change

Question title

Do you have any comments or questions regarding the proposed project?

Question title

Would you like to be added to the project email list for updates?

Project Comments

NCDOT accepts comments throughout all phases of project development.

All comments will be taken into consideration, and carry equal weight, regardless of submittal method.

To submit comments for consideration during the current phase of project development,

please submit before July 13, 2025.

The public is encouraged to leave comments using this webpage, email, or phone number:

Email: ewn-runway-williamsrd@publicinput.com

Phone Number:  984-205-6615    enter project code 11551 to leave a message

PROJECT CONTACT INFORMATION

Allison Thorburn, PE

Project Manager

NCDOT Highways Division 2

2815 Rouse Road Extenison

Kinston, NC 28504

    Title VI Feedback

To ensure we’re hearing from a broad set of voices, would you be willing to share (completely anonymously) some information about yourself?

If so, please click here https://publicinput.com/NCDOT-Title-VI

RESOURCES FOR PROPERTY OWNERS

Although the N.C. Department of Transportation works to minimize the number of homes and businesses displaced by a road project, it is inevitable, in many cases, that a certain amount of private property is needed. The following information explains right of way acquisition and answers questions about the process.

Right-of-Way Brochure Single Page Layout      Folleto del Proceso de Adquisición de Bienes Raíces
Right-of-Way Frequently Asked Questions

Right of way Acquisition Process Videos

English                                                                     Spanish

Project Timeline:

 Activity

Date*

Utilities

Fall 2026

Right of Way Acquisition

Spring 2026

Construction Begins

    Winter 2027

*Future dates subject to change
